Insurance and Risk Management for Factory Relocation Projects

The insurance and risk management for factory relocation projects should start well before the dismantling, packing and lifting, and moving of any equipment. A factory relocation entails relocating tools and machinery with high value including CNC machines, injection molding machines, production lines, etc. which are essential for the business. Cargo insurance is an effective measure of financial protection, but is best complemented with proactive risk management throughout the factory relocation process, from site survey through to production restart.

Some firms believe that having cargo insurance will protect their business’ move. However, if the process is not well planned and documented, insurance coverage might not address the loss of production time, repair delays, missing parts, installation problems, or conflicts with contractors. The best risk management involves insurance planning along with real-world safety measures such as detailed records of equipment, equipment condition reports, secure packing, lashing, route optimization, and post-move inspections. The aim is to limit financial risk, limit disruption to operations and help to get back to full production.

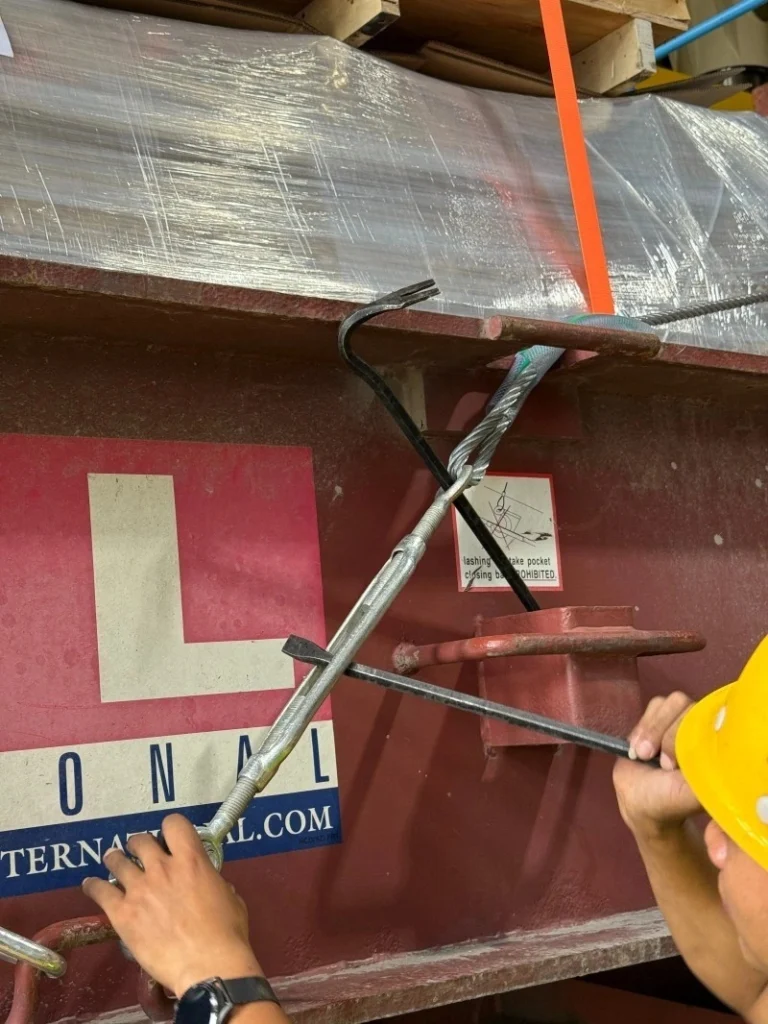

A close-up view of a worker's hands tightening a metal turnbuckle connected to a steel wire rope, anchored to the side of a shipping container or truck bed.

Why Insurance Matters in Factory Relocation Projects

The relocation of a factory involves considerable investment risk due to the value of industrial machinery and the risk of loss of business continuity. Insurance should be considered at the outset, rather than as an ‘afterthought’.

Insurance ConcernWhy It MattersExample Risk
Equipment ValueMachinery may be expensive and difficult to replaceCNC machines, molds, electrical cabinets, production lines
Handling RiskDamage can occur before transport beginsLifting impact, poor rigging, forklift collision
Transport RiskCargo may move, vibrate, or be exposed to weatherRoad vibration, ocean movement, port handling
Environmental RiskMoisture or corrosion may damage machineryRust, electrical faults, mold corrosion
Theft or LossSmall parts or high-value components may be misplacedTools, sensors, spare parts, control units
Contractor ResponsibilityMultiple parties may handle the same cargoDisputes over where damage occurred
Documentation QualityClaims require evidenceMissing photos, unclear handover notes

Early insurance review will help to determine any coverage gaps and make sure that declared values, policy terms and coverage provided are consistent with the project scope.

Common Risks in Factory Relocation Projects

The relocation risks are not only physical damage to the transports. These occur at all stages and may result in expensive repairs, lengthy downtime or safety incidents.

Risk TypeWhen It HappensPossible Impact
Dismantling DamageDuring disconnection or component removalBroken parts, wiring errors, reinstallation delays
Lifting DamageDuring crane, forklift, gantry, or rigging workFrame deformation, impact damage, safety incident
Packaging FailureBefore or during transportRust, scratches, dust, vibration damage
Cargo ShiftingDuring road, port, or ocean transportEquipment collision or structural damage
Moisture ExposureOutdoor loading, storage, ocean freightCorrosion and electrical issues
Missing ComponentsDuring dismantling, packing, or handoverDelayed installation and restart
Transport DelayRoad permits, weather, customs, port congestionExtended downtime or storage costs
Installation ErrorDuring positioning, reconnection, or calibrationPoor machine performance after restart

By knowing these risks, project teams can prioritize risk mitigation measures alongside insurance policies to complement long-term protection.

Step 1: Conduct a Factory Relocation Risk Assessment

Comprehensive risk assessment should be done before contractors start working in the house. This action is used to determine vulnerabilities and to inform on protection strategies and insurance decisions.

Risk Assessment ItemWhat to EvaluateWhy It Matters
Equipment ValueReplacement value and repair difficultyHelps determine insurance and protection level
Production CriticalityWhether downtime affects output or customer ordersSupports priority and contingency planning
Equipment ConditionExisting wear, cracks, rust, leakage, or damagePrevents claim disputes
Size and WeightDimensions, gross weight, center of gravityDetermines lifting, transport, and securing method
Sensitivity LevelVibration, moisture, dust, tilt, or calibration sensitivityDefines packaging and monitoring requirements
Site AccessDoorways, floor load, loading area, route limitsReduces handling delays and accidents
Transport RoutePermits, road conditions, port handling, customsReduces delay and compliance risk
Destination ReadinessFoundation, utilities, installation spacePrevents storage and restart delays

The teams that invest time in this assessment early, will make better decisions on packaging, transport methods and selection of contractors.

Step 2: Understand What Insurance May and May Not Cover

Coverage will differ from policy to policy, declared value to declared value, route to route, cargo to cargo, and packing and securing requirements. Make sure to go over certain conditions with your insurance provider or agent.

Insurance ConsiderationWhat to CheckWhy It Matters
Declared Cargo ValueWhether machinery value is accurately declaredUnderinsurance may reduce recovery
Covered StagesDismantling, loading, transport, unloading, storage, installationSome policies may not cover every stage
ExclusionsRust, poor packing, delay, wear, hidden damage, improper handlingHelps avoid false assumptions
Packing RequirementsWhether insurer requires specific packaging or securingPoor packing may affect claims
Theft or Loss CoverageWhether components and accessories are includedSmall parts can be costly to replace
DeductibleAmount paid before insurance respondsAffects real financial exposure
Claim EvidencePhotos, reports, invoices, handover recordsStrong documentation supports claims
Contractor LiabilityWho is responsible at each stageReduces disputes between parties

Communication with insurers regarding details of the project helps to align expectations and documentation requirements.

Step 3: Document Equipment Condition Before the Move

Well-documented information is key to achieving successful claims and smooth transfers. It is a proof of the pre-move condition of the equipment and can facilitate the speedy resolution of disputes.

Documentation ItemWhat to IncludeWhy It Supports Risk Management
Equipment ID RecordName, model, serial number, locationConfirms what equipment was moved
Photo RecordAll sides, control panels, bases, accessoriesShows pre-move condition
Existing Damage NotesRust, cracks, dents, leaks, worn partsPrevents false damage disputes
Operational StatusWhether equipment was functional before shutdownHelps evaluate post-move issues
Component ListRemoved parts, cables, tools, fixturesReduces missing-part risk
Packing ListCrate numbers, contents, protection methodSupports handover and claims
Sign-Off RecordResponsible person and dateCreates accountability

Photographs and written records made prior to the dismantling are of great value later on.

Step 4: Reduce Risk Through Packaging, Securing, and Monitoring

Practical protective measures can help make insurance more effective.There are practical insurance protection measures, which can help make insurance as effective as possible by preventing or limiting damage. The lessons from the Bentlee experience concerning OOG cargo illustrate the benefits of custom solutions like wooden crating, vacuum sealing and suitable lashing.

Risk Control MethodRisk ReducedPractical Note
Wooden CratingImpact and handling damageUseful for components and fragile parts
Vacuum SealingMoisture and corrosionUseful for rust-sensitive machinery or molds
Desiccants and VCIHumidity and rustImportant for ocean or long-distance transport
Shock-Absorbing PadsVibration and hidden mechanical stressUseful for precision equipment
Control Panel ProtectionElectrical and display damageProtects wiring, screens, and sensors
LashingCargo movementMust use proper angles and rated restraints
Blocking and BracingSliding, tipping, and collisionShould work together with lashing
GPS Tracking & SensorsSchedule uncertainty and hidden eventsUseful for high-value or sensitive cargo

These techniques in conjunction with 3D load planning and specialist trailers, provide a serious contribution to overall risk controls.

Step 5: Define Contractor Responsibility and Handover Points

Usually, a factory relocation process has more than one party. Staying clear at each handover of each responsibility reduces disputes and enhances claim positions.

Project StageResponsible Party to DefineRequired Record
DismantlingFactory team or dismantling contractorCondition and component record
PackingPacking provider or relocation contractorPacking list and photos
LoadingRigging crew and lifting operatorLoading photos and lashing record
TransportTrucking provider or freight forwarderDelivery note and tracking record
Customs or Port HandlingCustoms broker, forwarder, or terminalClearance and handover records
UnloadingDestination rigging or unloading teamArrival inspection report
InstallationInstallation or maintenance teamTesting and acceptance record

A responsibility matrix is shared by all parties which assists in holding everyone accountable during the project.

Step 6: Manage Delay and Business Interruption Risks

Not all losses are tangible. Delays can result in a great deal of economic loss due to lost production.

Delay RiskPossible Business ImpactRisk Control Method
Permit Approval DelayCargo cannot depart on scheduleCheck permit needs early
Customs DelayEquipment held at border or portPrepare documents before shipment
Weather DisruptionLoading, transport, or port handling delayedBuild schedule buffer
Destination Not ReadyEquipment waits before installationPrepare foundation and utilities early
Missing PartsReinstallation cannot proceedUse labeling and inventory records
Damage After ArrivalRepair and restart delayInspect immediately and document condition
Calibration DelayProduction quality cannot be confirmedReserve testing and calibration window

These risks can be further reduced by phased relocation or temporary production arrangements.

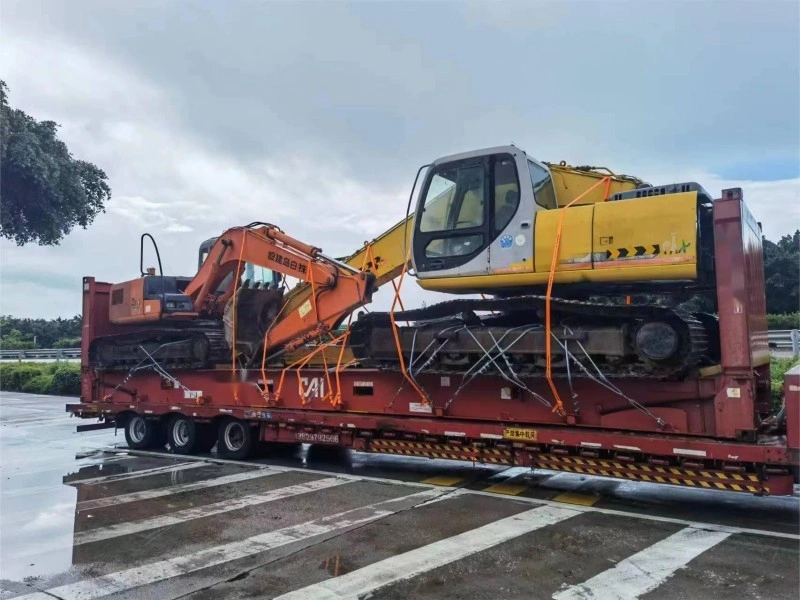

Two heavy excavators, one yellow and one orange, securely strapped onto a red lowbed flatbed trailer for long-distance transport.

Step 7: Prepare a Claim-Ready Documentation File

Advanced organization of documents helps expedite any claims process and shows due diligence.

Claim-Ready DocumentPurpose
Insurance Policy and Coverage NotesConfirms coverage terms and exclusions
Equipment InventoryShows what was included in the project
Declared Value RecordSupports valuation review
Pre-Move PhotosShows equipment condition before relocation
Packing PhotosDemonstrates protection method
Loading and Lashing PhotosShows cargo handling and securing condition
Handover RecordsTracks responsibility between parties
Sensor DataShows shock, tilt, humidity, or temperature events
Damage ReportRecords visible issues after delivery
Repair EstimateSupports cost evaluation

Common Insurance and Risk Management Mistakes to Avoid

Even veteran teams can miss things that make protection less effective.

MistakeWhy It Creates RiskBetter Practice
Not Reading Policy TermsCoverage may exclude key risksReview terms with insurer or broker
Under-Declared ValueRecovery may be limitedDeclare realistic cargo value
No Condition ReportDifficult to prove when damage occurredDocument equipment before dismantling
Weak Packing RecordsClaims may be harder to supportPhotograph packaging and protection methods
No Handover RecordsResponsibility becomes unclearUse sign-off forms at each stage
Poor Moisture ProtectionRust may be disputed or excludedUse VCI, desiccants, barriers, or vacuum sealing
Late Damage InspectionEvidence may be lostInspect immediately after arrival
Treating Insurance as Substitute for PlanningInsurance may not prevent downtimeCombine insurance with practical protection

Factory Relocation Insurance and Risk Management Checklist

Refer to this checklist when preparing.

StageInsurance and Risk Management Checklist
Before PlanningIdentify equipment value, production criticality, hazards, sensitivity, and relocation scope
Insurance ReviewCheck coverage terms, exclusions, declared value, deductible, covered stages, and claim requirements
Risk AssessmentEvaluate damage, theft, delay, moisture, lifting, transport, and installation risks
DocumentationRecord equipment condition, serial numbers, photos, component lists, and packing requirements
Contractor CoordinationDefine responsibilities, handover points, damage reporting, and communication workflow
Protection MeasuresPlan packaging, moisture control, lashing, blocking, bracing, and monitoring
During TransportTrack cargo status, maintain records, and document any incidents
After DeliveryInspect equipment, record condition, report damage promptly, and complete acceptance records
Post-Move ReviewConfirm repairs, calibration, production readiness, and documentation closeout

Conclusion — Insurance Works Best When Risk Is Managed Before the Move

Financial exposure to projects of relocating factories can be minimised with insurance, but this is most effective in combination with good practice risk management. Early Assessment, detailed documentation, use of appropriate packaging and securing, ensuring that responsibilities are clear between companies, monitoring transport and post-delivery inspections – all of these help companies to safeguard their assets and production schedules.

The process of relocation of factories is complex but a well-designed approach to prevention and evidence can make a big difference. When these elements are carefully considered, these occurrences can be managed and a “disruptive project” become a “controlled transition” that does not cause your business to be brought to a halt.
