Top Challenges in International Factory Relocation and How to Overcome Them

An international factory move is more complicated than an ordinary equipment move. It includes engineering logistics, customs clearance, heavy equipment transport and production continuity planning. The risks increase when machinery is oversized, precision-based, high value, hazardous, or rust prone—and this can mean cargo damage, port delays, customs holds, unexpected costs, missed installation windows and longer periods of production downtime.

Often relocation is thought of as a straightforward freight shipping process, but the greatest risks are found before and after shipment, with incomplete documentation, lack of accurate equipment information, poor packing for export, unclear responsibilities, and unprepared destination locations. Best practice is to treat it as part of a full international relocation of factory work projects, with risk assessment and detailed planning prior to any dismantling works.

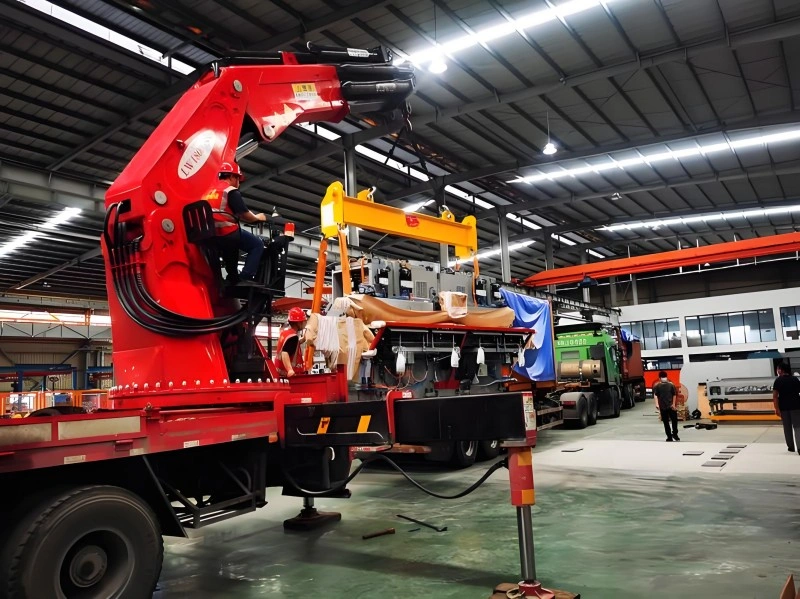

A red mobile crane lifting a large piece of industrial equipment inside a factory warehouse, with workers guiding the load safely onto a flatbed truck.

Why International Factory Relocation Is More Complex Than Domestic Moves

The complexity of relocating a factory overseas is often not faced in domestic moves. The combination of longer transit times, multi-modal coordination, dual customs processes, port handling and varying regulations add risk and time.

An overseas move is different to a local road move within the country as it involves equipment being brought into contact with ocean humidity, a number of handling stages, language challenges and tough import requirements. Additionally, new site conditions and compliance rules makes reinstallation and production restart more difficult.

FactorDomestic Factory RelocationInternational Factory Relocation
Transport ScopeUsually road-based within one countryInland transport, port handling, ocean/air freight, destination delivery
DocumentationRelatively simpleExport documents, customs declarations, packing list, permits, certificates
Risk ExposureShorter transit and fewer handling pointsLonger transit, multiple transfers, sea exposure, customs delays
ComplianceLocal rules onlyExport, import, port, transport, and possibly hazardous goods regulations
Packaging NeedsOften basic protection may be enoughExport-grade protection, moisture control, rust prevention, shock protection
CoordinationFewer parties involvedFactory, packers, truckers, freight forwarders, customs brokers, port operators, installers

Challenge 1: Inaccurate Equipment Data Before Relocation

The first step in any successful international factory relocation is to have reliable cargo information. An excellent transport plan can only be ruined if it is not as detailed as the specifics.

Information such as exact dimensions, actual weight, center of gravity, lifting point, foundation requirements, electrical requirements, hydraulic requirements, dismantled parts lists, and HS codes are all important considerations. Another important thing to know is if there is oversized cargo (OOG), hazardous, fragile, rust sensitive or high value cargo.

Data NeededWhy It MattersRisk If Incorrect
DimensionsDetermines container, flat rack, trailer, and route feasibilityWrong transport method or space booking failure
WeightAffects lifting, trailer selection, and port handlingOverload risk or rejected cargo handling
Center of GravitySupports safe lifting and load securingTipping or unstable lifting
Equipment DescriptionRequired for customs and insuranceCustoms delays or incorrect declaration
Dismantled Parts ListSupports packing and reinstallationMissing parts or installation confusion
Equipment ConditionHelps prove pre-move statusDisputes after delivery

Challenge 2: Customs Clearance and Documentation Errors

An international factory relocation delay issue that is still prevalent is documentation errors. The slightest discrepancy can tie up ships at port for months at a time.

The commercial invoice, packing list, detailed equipment descriptions, correct HS code information, correct serial numbers, used machinery declarations, permits and inspection records are all important documents. Oils, batteries or chemicals, etc. that are hazardous require special declarations.

Document or RequirementPurposeCommon Problem
Commercial InvoiceDeclares value and transaction detailsIncorrect value or incomplete consignee details
Packing ListShows cargo quantity, dimensions, and weightMissing parts or inconsistent cargo data
HS CodeDetermines customs classificationWrong classification causing inspection or duties issue
Serial Number RecordIdentifies used machineryMissing equipment identity information
Used Equipment DeclarationRequired in some marketsDelays due to unclear equipment status
Hazardous Component DeclarationIdentifies batteries, oils, chemicals, or restricted itemsCompliance problems or cargo rejection
Import PermitRequired for certain equipment or marketsShipment arrives before permit approval

Challenge 3: Choosing the Right Transport Method for Industrial Equipment

The choice of transport method plays a crucial role in the success of international factory relocation, affecting factors such as safety, cost, and time. It will depend on the equipment, the sensitivity, the route, the time and the infrastructure at the destination.

These include flat and open top containers for taller or wider machines, lowbed trailers for interland transfers, breakbulk or RoRo shipping for larger units and heavy lift vessels for extremely heavy cargo.

Transport MethodBest ForLimitation
Standard ContainerSmall machines or packed componentsNot suitable for oversized equipment
Open Top ContainerTall machinery that can be loaded by craneHeight and weight restrictions still apply
Flat Rack ContainerWide, heavy, or irregular equipmentRequires strong lashing and port approval
Lowbed TrailerInland transport of tall or heavy machineryMay require road permits and route survey
Breakbulk ShippingLarge equipment not suitable for containersMore handling exposure and planning complexity
RoRo ShippingWheeled or towable equipmentNot suitable for all factory machinery
Heavy Lift VesselExtremely large or heavy project cargoHigher planning and booking requirements

Challenge 4: Export Packaging and Equipment Protection

When shipping machinery to other countries with several handling and transport stages, sea conditions and the possibility of storage delays, export packing is necessary. Corrosion, impact damage and contamination are avoided with proper protection.

Some of the effective packaging methods include using strong wooden crates, vacuum packaging, moisture barrier packaging with desiccants, anti-rust materials (VCI), shock-absorbing packaging, edge protection and control cabinet wrapping. Proper photo documentation throughout enhances insurance claims.

Protection MethodRecommended ForRisk Reduced
Wooden CratingComponents, accessories, precision partsImpact and handling damage
Vacuum SealingRust-sensitive machinery or metal equipmentMoisture and corrosion
DesiccantsLong-distance export shipmentsInternal humidity buildup
VCI MaterialsExposed metal surfacesRust during ocean transport
Shock ProtectionPrecision equipment or control systemsVibration and impact damage
Edge ProtectionPainted or machined surfacesScratches and surface damage
Control Cabinet WrappingElectrical panels and displaysDust, moisture, and collision damage

Challenge 5: Oversized Cargo Permits, Route Planning, and Port Restrictions

Many industrial machines are too large to fit on road, bridge, or port standards and require detailed planning of the route and the preparation of permits; this is often the case for a relocation of a factory to an international location.

Some critical checks that are performed are: road permits, bridge load limits, turning radius, utility line heights, port crane capacity, terminal acceptance rules, and requirements for police escorts or pilot vehicles.

Planning ItemWhat to ConfirmPossible Consequence If Ignored
Road RouteBridges, tunnels, road width, turning radiusCargo cannot pass safely
Height ClearanceOverpasses, gates, wires, container limitsRoute changes or delays
Weight LimitRoad, bridge, trailer, and port limitsPermit rejection or safety risk
Port HandlingCrane capacity, lifting gear, terminal rulesCargo handling delay or rejection
Container ApprovalOOG dimensions and securing planBooking cancellation or extra charges
Escort RequirementsPilot car or police escort rulesLegal and safety issues

Challenge 6: Production Downtime and Schedule Coordination

One of the top priorities in any factory relocation is to minimize production downtime. Just bringing in equipment is not enough to get the system running quickly, there is also a need to be ready at the site and plan it in phases.

Successful projects include shutting down windows, critical machine prioritisation, buffer stock, destination preparation and built-in shutdown and installation buffers.

Schedule RiskImpact on ProductionPrevention Method
Late DismantlingDelays loading and export scheduleConfirm dismantling plan early
Customs DelayEquipment cannot reach destination on timePrepare documents before shipment
Site Not ReadyMachinery arrives but cannot be installedPrepare foundation, power, and utilities in advance
Missing PartsReinstallation cannot proceedLabel and pack components systematically
No Testing WindowProduction restarts with hidden issuesReserve time for calibration and trial runs
Poor Sequence PlanningCritical machines arrive too lateMove priority equipment first

Challenge 7: Communication Across Multiple Contractors and Countries

When relocating a factory internationally, there are usually many stakeholders involved in the process and effective communication helps to avoid expensive errors and double handling.

Party InvolvedKey ResponsibilityInformation They Need
Factory TeamEquipment access and shutdown planningProduction schedule, equipment details
Dismantling TeamSafe removal and labelingDrawings, utilities, component list
Packing TeamExport-grade protectionEquipment sensitivity and packaging standard
Transport ProviderInland movementSize, weight, route, permit needs
Freight ForwarderBooking and shipping coordinationCargo data and documentation
Customs BrokerExport/import clearanceInvoice, packing list, HS code, permits
Installation TeamReassembly and commissioningPhotos, labels, drawings, sequence plan

Challenge 8: Insurance, Liability, and Risk Documentation

When it comes to high value machinery, it requires extensive coverage and detailed documentation during the moving process. Smooth claims if problems occur due to clear records of equipment condition, packaging, loading and lashing.

Documentation ItemWhy It HelpsWhen to Prepare
Equipment Condition ReportRecords pre-move statusBefore dismantling
Packing PhotosShows protection methodDuring packaging
Loading PhotosRecords handling and positioningDuring loading
Lashing ReportShows securing methodBefore departure
Insurance ValueSupports coverage and claimsBefore shipment
Handover ChecklistConfirms responsibility transferAt each major handover point

Challenge 9: Destination-Site Readiness and Post-Move Installation

After the arrival of the cargoes, many projects encounter delays due to the lack of full preparation of the new facility. All foundation strength, access routes, utility connections, lifting equipment and alignment tools need to be available beforehand.

Destination-Site RequirementWhy It MattersRisk If Not Ready
Foundation and Floor StrengthSupports stable machinery operationInstallation delay or unsafe setup
Access RouteAllows unloading and positioningEquipment stuck at site entrance
UtilitiesProvides power, air, water, or hydraulic supportMachine cannot be tested
Lifting EquipmentEnables safe unloading and positioningExtra rental cost or schedule delay
Alignment and Leveling ToolsSupports precision operationPoor production accuracy
Trial Run PlanConfirms equipment performanceHidden problems after restart

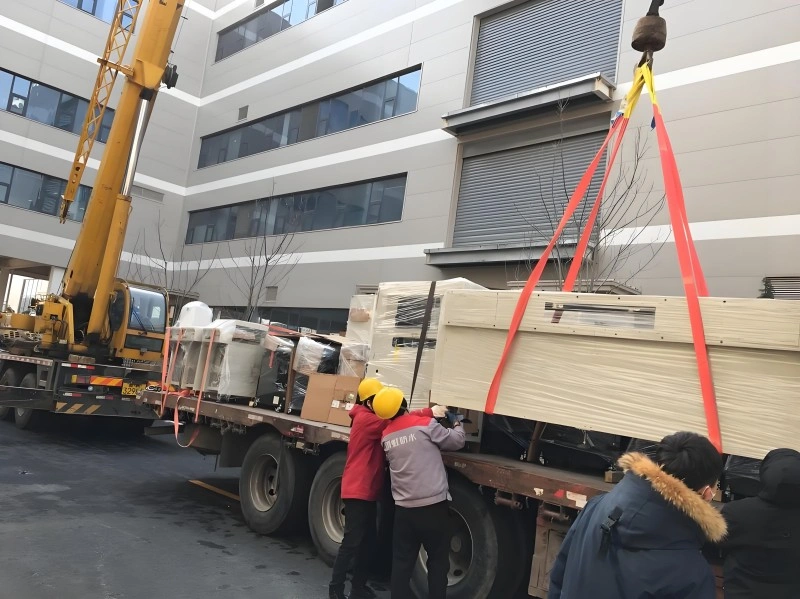

Workers in safety helmets guiding a large wooden crate suspended by orange lifting straps from a yellow crane outside a modern industrial building.

How to Reduce Risk in International Factory Relocation

Structured early planning and professional management is the most effective approach to risk management. Carry out two-site surveys; compile comprehensive equipment inventories; ensure that all customisation needs are identified early; decide on an appropriate matching of packages to transport conditions; have unambiguous responsibility matrices.

Risk Control StepPractical ActionResult
Early PlanningBegin before shutdown or dismantlingFewer last-minute changes
Dual-Site SurveyInspect origin and destination facilitiesBetter access and installation planning
Documentation ReviewCheck customs and import requirements earlyLower clearance delay risk
Export Packaging PlanMatch protection to route and cargo sensitivityReduced damage and corrosion risk
Schedule BufferAllow time for customs, weather, and port delaysMore realistic relocation timeline
Central CoordinationAssign one project leadClearer communication and accountability
Post-Move TestingInspect and calibrate before production restartSafer return to operation

Conclusion — International Factory Relocation Requires Project-Level Control

The successful international factory relocation takes place when each step is seen as a component of a continuous project. The outcome is influenced by the accuracy of equipment data, the documentation that’s in compliance with the regulations, the method of transport, the type of packaging, route planning and installation of equipment after the move. When companies are able to identify the risk early and get each contractor under control, they can minimize the chance of delays, protect their valuable machinery, and get the production back on track without any/aggressive surprises.

By adopting factory relocation in the context of a professional engineering logistics project and not just a freight shipment, manufacturers can achieve better results in every relocation with consistency.
