Best Practices for Shipping High-Value Power Plant Equipment

OOG logistics for high-value power plant equipment involves the following processes: cargo survey, engineering review, route feasibility, transport equipment selection, lifting method, cargo protection, lashing design, documentation, customs clearance, insurance, and final delivery coordination. That is why it is necessary to adopt this approach as this type of cargo is often oversized, overweight, fragile, high value and schedule critical, making it a project logistics challenge.

Transformers, turbines, generators, boilers, pressure vessels, control cabinets, heat exchangers and power modules are common power plant equipment. Each piece requires special handling to avoid damage, corrosion, vibration concerns, route restrictions, crane mismatches, permit delays, port issues, customs holds, theft and/or project delays. The best shippers begin planning long before goods are shipped from the factory. A dependable transportation plan not only ensures the safety of the equipment but also contributes to the project’s overall timeline.

The shipping of large, expensive high-value power plant equipment is not just about transporting heavy materials; it’s about safeguarding project assets, managing transport risk and ensuring installation timelines are kept on track. While many shippers would think that taking power plant equipment across country is the same as transportation of any other heavy machinery, there are many project logistics issues that make the job more complex, including electrical sensitivity, corrosion risks, lifting constraints, route feasibility, insurance considerations and installation deadlines.

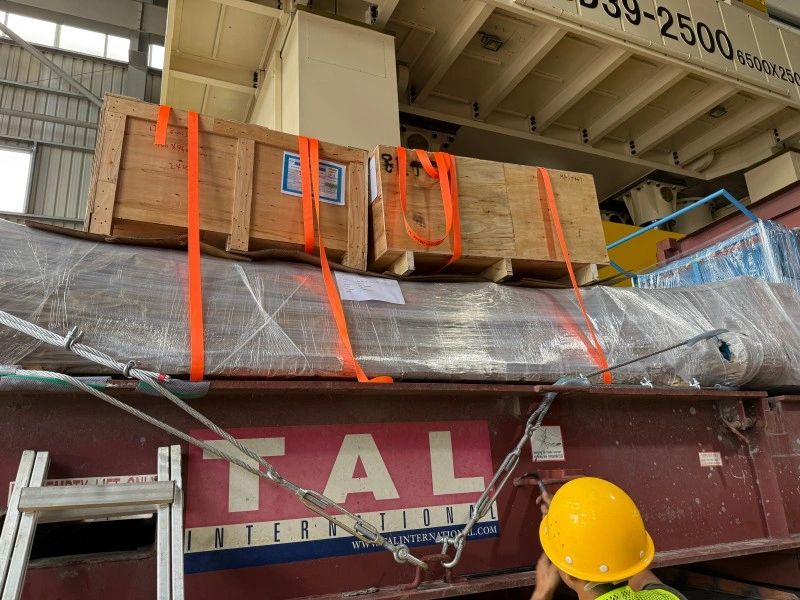

Heavy machinery wrapped in protective film and secured with orange straps on a TAL flat rack container, with a worker overseeing the loading process.

Why Power Plant Equipment Requires Specialized Shipping Planning

Power plant equipment involves more careful logistics planning as it is a combination of high value, technical sensitivity, heavy weight, large dimensions and tight project time.

Planning FactorWhy It Matters for Power Plant Equipment
High Cargo ValueDamage can create major financial and project impact
Long Replacement Lead TimeA damaged unit may delay installation or commissioning
Oversized DimensionsMay require OOG route permits, flat rack, breakbulk, or heavy lift transport
Heavy WeightAffects trailer selection, crane capacity, axle load, and port handling
Technical SensitivityElectrical, rotating, or precision components may need special protection
Moisture RiskTransformers, generators, and control cabinets may be sensitive to humidity
Lifting RequirementsIncorrect lifting points may damage structure or internal systems
Project TimelineDelays can affect construction, installation, and commissioning schedules

In a perfect world, these all line up, and one mistake can cause weeks of downtime or millions of dollars in additional expenses. For this reason, the experienced teams do not consider each shipment as a common freight but rather as a complete project.

Common Types of Power Plant Equipment Shipped as OOG Cargo

Each type of power plant equipment has a specific protection and transport requirement.

Equipment TypeCommon Shipping Concern
Power TransformersHeavy weight, moisture protection, shock control, center of gravity
TurbinesPrecision components, vibration protection, lifting control
GeneratorsElectrical system protection, heavy lifting, corrosion prevention
BoilersLarge dimensions, heavy structure, route and port handling limits
Pressure VesselsLength, support saddles, coating protection, lifting method
Heat ExchangersFragile tubes, long structure, moisture and impact protection
Control CabinetsElectrical sensitivity, moisture protection, secure packaging
Power ModulesLarge footprint, multiple lifting points, project schedule coordination
Steel StructuresOver-length or over-width dimensions, securing and deformation prevention

Knowing these intricacies in advance enables logistics teams to choose the most appropriate equipment, packaging, and securing solutions for each individual load.

Best Practice 1: Start with a Detailed Cargo Survey

Reliable cargo information is key to safe and economical power plant equipment shipping. In the case of high value turbines, generators, transformers and other power plant equipment,  and other power plant equipment, premium OOG logistics services should begin with verified cargo data, route feasibility review, and protection planning before shipment execution.

Cargo Survey ItemWhy It Matters
Verified DimensionsDetermines transport method, route clearance, and carrier acceptance
Final Packed SizePrevents mismatch between cargo data and booking details
Gross WeightAffects crane, trailer, vessel, and permit requirements
Center of GravitySupports safe lifting, load positioning, and stability review
Lifting PointsHelps plan crane loading and unloading safely
Support PointsPrevents deformation during storage and transport
Sensitive ComponentsIdentifies areas needing shock, moisture, or security protection
Technical DrawingsSupports engineering review and load planning
Cargo PhotosHelps identify protrusions, access points, and protection needs

No guesswork in onsite measurements and detailed documentation. Companies that invest the time here repeatedly reduce the number of change orders and risk, and enjoy smoother bookings.

Best Practice 2: Choose the Right Transport Method

The choice of shipping method must be determined by the characteristics of the goods and the project itself, and not just the price.

Transport MethodBest Used ForPlanning Consideration
Lowbed TrailerTall or heavy equipment for inland movementRoute clearance, axle load, loading site access
Modular TrailerExtremely heavy transformers, modules, or vesselsAxle configuration, route survey, ground bearing capacity
Flat Rack ContainerOOG cargo within containerized shipping limitsLashing, weather protection, carrier approval
Open Top ContainerOver-height cargo that fits within container wallsTop loading, wall clearance, tarpaulin protection
Breakbulk ShippingCargo too large or complex for containerized transportPort capability, lifting method, stowage planning
RoRo ShippingWheeled or rollable cargoRamp access, cargo condition, port availability
Heavy Lift VesselExtremely heavy or oversized project cargoHeavy lift planning, vessel schedule, engineering review

The right choice is one that is safe, cost effective, and involves following a schedule. Early dialogue with logistics partner and a generator may not be appropriate for a long heat exchanger.

Best Practice 3: Plan Route Feasibility Before Cargo Pickup

Oversized, overweight and hard-to-move units of power plant equipment are common, making route planning critical.

Route Planning FactorWhy It Matters
Bridge ClearancePrevents over-height cargo from being blocked during transit
Road WidthDetermines whether wide cargo can pass safely
Turning RadiusCritical for long equipment or modular transport systems
Axle Load LimitsAffects permit approval and route legality
Overhead ObstaclesCables, signs, and gates may require adjustment or rerouting
Escort RequirementsSupports safe road movement and regulatory compliance
Port AccessConfirms cargo can enter terminal areas
Site AccessEnsures final delivery location can receive and unload cargo
Movement Time WindowsHelps avoid restricted travel periods or delays

A detailed survey is likely to show that permits, escorts or minor adjustments to the route are required, and it’s possible to deal with those weeks before the transport day, far easier than trying to deal with them on the same day.

Best Practice 4: Match Lifting Equipment to the Real Loading Condition

Crane selection must be determined by the actual lifting conditions other than the cargo weight.

Lifting FactorWhy It Matters
Gross WeightDefines minimum crane capacity requirement
Rigging WeightMust be included in total lifting load
Working RadiusCrane capacity decreases as radius increases
Center of GravityAffects balance and lifting stability
Lifting PointsPrevents structural damage during handling
Sling AngleAffects force on cargo and rigging equipment
Ground Bearing CapacityEnsures crane setup remains stable
Weather ConditionsWind and rain may delay or restrict lifting
Final PlacementCrane must place cargo accurately on trailer, container, or support

Accurate calculations and on-site supervision ensure that there are no tips or bent frames or dropped parts—which are costly and hazardous.

Best Practice 5: Use Proper Lashing, Blocking, and Bracing

Power plant equipment security is paramount because of the potential for significant damage during cargo movement during transport by road or ocean.

Securing MethodPurposeKey Consideration
LashingRestrains cargo against movementMust match cargo weight and transport forces
BlockingPrevents sliding during braking, turning, or vessel motionShould align with support points
BracingAdds structural restraint for irregular or unstable cargoMust not damage sensitive components
Anti-Slip MaterialIncreases friction between cargo and support surfaceHelps reduce movement under vibration
Timber / Steel SupportsDistributes weight and protects cargo surfacesMust match cargo structure and point loads
Edge ProtectionProtects straps, chains, and painted surfacesImportant for high-value equipment
Post-Securing InspectionConfirms restraint system is properly installedShould be documented with photos

Professional plans for lashing are tested against expected sea and road forces and everyone can therefore be sure of a safe arrival of the load.

Best Practice 6: Protect Against Moisture, Corrosion, and Vibration

Much of the power plant equipment with higher value needs greater protection than normal heavy load.

Protection NeedRecommended Control
Moisture ProtectionMoisture barrier bags, vacuum sealing, desiccants, sealed covers
Corrosion PreventionAnti-rust oil, VCI film, VCI paper, surface protection
Sea ExposureHeavy-duty tarpaulin, drainage design, salt-spray protection
Electrical SensitivitySeal control cabinets, connectors, and wiring areas
Vibration RiskUse shock-absorbing supports and stable load positioning
Surface DamageEdge protection, padding, and non-abrasive covers
Long StoragePeriodic inspection, humidity indicators, and secure storage
Claim SupportPre-shipment photos and protection records

Such measures are particularly critical for electrical or precision parts that are not meant to withstand exposure to moisture or salt water, even for a short period of time.

Best Practice 7: Prepare Export Documents and Customs Information Early

Detailed documents might be required for customs, carrier approval and destination delivery for power plant equipment.

DocumentWhy It Matters
Commercial InvoiceSupports customs value and transaction details
Packing ListConfirms dimensions, weight, package count, and packing method
Bill of LadingActs as transport document and cargo receipt
HS CodeDetermines classification, duties, and regulatory requirements
Certificate of OriginSupports origin verification or trade preference claims
Technical SpecificationsHelps customs understand equipment function and components
Drawings / PhotosSupports carrier, port, and customs review
Insurance CertificateDocuments cargo risk coverage
DG DocumentsRequired if batteries, oil, gas, or other regulated components apply
Import PermitMay be required for destination-country clearance

Last minute holds can waste valuable cranes and/or projects if they can be prevented by proper pre-planning.

Best Practice 8: Arrange Insurance and Condition Records

Insurance should complement preventive logistics controls, not take their place.

Insurance / Record ItemWhy It Helps
Declared Cargo ValueSupports correct insurance amount
Insurance CertificateConfirms coverage details and insured route
Pre-Shipment PhotosDocuments cargo condition before movement
Packing PhotosShows protection method and cargo readiness
Loading PhotosConfirms handling and placement condition
Lashing PhotosDocuments securing method before departure
Handover RecordsTracks responsibility between parties
Survey ReportProvides independent condition assessment if needed
Incident Report ProcessHelps respond quickly if damage or loss occurs

In the event of an unexpected occurrence, comprehensive records will make potential disputes a simple claim.

Best Practice 9: Coordinate Port Handling and Final Site Delivery

The moment cargo arrives at the port, the job of power plant equipment shipping is not finished; final delivery is one of the most important and crucial moments.

Coordination AreaWhy It Matters
Origin Port HandlingConfirms crane, storage, and terminal acceptance
Destination Port CapabilityEnsures cargo can be discharged safely
Customs ClearancePrevents cargo hold and storage charges
Final Delivery PermitsAllows oversized cargo to move legally from port to site
Site AccessConfirms roads, gates, and unloading space are suitable
Unloading EquipmentEnsures crane or lifting gear is ready on arrival
Installation ScheduleAligns delivery with project work sequence
Temporary StorageProvides backup if site is not ready

The final leg of the journey proceeds as smoothly as the first, thanks to good communication on all sides.

A row of white Maersk refrigerated shipping containers featuring Carrier refrigeration units, ready for cold chain logistics.

Common Mistakes When Shipping Power Plant Equipment

Even the experts can get in a rut that causes more work than is needed.

MistakePossible Consequence
Late PlanningLimited equipment options, higher cost, or schedule delay
Estimated Cargo DataWrong trailer, container, crane, or route selection
No Center-of-Gravity ReviewLifting and transport stability risks
Choosing by Price OnlyHigher risk of damage, delay, or re-handling
Weak PackagingMoisture, corrosion, or vibration damage
No Route SurveyBridge, road, or port access problems
Poor DocumentationCustoms hold or carrier approval delay
No Insurance RecordsDifficult claim support if damage occurs
Ignoring Site AccessFinal delivery may fail after cargo arrives
No Contingency PlanWeather, port, or permit issues may disrupt the project

The keys to avoiding these pitfalls are discipline and early involvement of specialists.

What Shippers Should Prepare Before Requesting a Transport Plan

Full information helps logistics teams plan a safer, more accurate and cost-controlled plan.

Information to PrepareWhy It Helps
Verified DimensionsSupports trailer, container, route, and carrier planning
Gross WeightDetermines crane, trailer, vessel, and permit requirements
Center of GravitySupports lifting, load positioning, and stability review
Lifting PointsHelps plan safe crane loading and unloading
Support PointsPrevents deformation during storage and transport
Technical DrawingsHelps understand structure, handling limits, and cargo layout
Cargo PhotosReveals protrusions, fragile areas, and protection needs
Packaging RequirementsSupports moisture, shock, and corrosion protection
Origin / DestinationEnables route, port, and final delivery planning
Delivery DeadlineHelps align transport schedule with project milestones
Insurance NeedsSupports risk planning and condition documentation

This data can be used in making accurate quotations and realistic timelines, when provided early.

Common Misunderstandings About Shipping Power Plant Equipment

There are still some myths floating around in the project team’s heads:

  • Heavy cargo is not the only thing that power plant equipment is.
  • The transport plan should commence prior to packaging and booking.
  • The lowest cost shipping may not be the lowest risk option.
  • Cargo protection is a critical function as well as freight routing.
  • Insurance is no substitute for correct packaging, inspection and securing.
  • Final delivery and site unloading can be more difficult than ocean shipping.
  • Route survey, crane planning, and the design of lashing should not be done at the last minute.

Condition records, or condition statements, are crucial for quality control, insurance, and prevention of disputes.

Conclusion — Power Plant Equipment Shipping Requires Full-Chain Risk Control

Early logistics planning and a full-chain risk-control process enables high-value power plant equipment to be transported safer. Shippers can avoid damage, delays and disruption to their projects by verifying the cargo data, selecting the appropriate mode of transport for the cargo, protecting sensitive components, coordinating lifting, securing cargo, preparing documents, and planning final delivery. The secret is to regard each shipment as the project milestone it is!
